5 Shell Elements

The fundamentals to achieve Wind and Weathertight.

Foundations

Minimise the cost by maximising the foundation stability.

Walls & Floors

Your chosen system defines the design and construction process.

Roof

Dictates internal space, construction speed and aesthetic.

The installation of the five wind and weathertight elements will always involve a combination of time periods that will form the Critical Path of the project schedule. The Critical Path in a project schedule is the longest sequence of dependent tasks that determines the shortest possible duration to complete the entire project, where any delay in these tasks directly delays the overall finish date.

  • Foundations: The essential start, as nothing can be built until these are installed and the concrete sufficiently cured.
  • Walls: Must be complete to support the roof and floors above and they need scaffolding.
  • Floors: Provide working platforms and if the building lacks a structural frame (As most residential buildings do) the structural integrity.by bracing the walls against wind loading.
  • Roof: Once the roof structure is in place, the building is protected from rain and it needs scaffolding.
  • Exterior Doors and Windows: These seal the envelope, making the building truly weathertight and they need scaffolding.

Every day lost in this phase translates directly into increased site costs, wage bills, and potential budget overruns. Skill and experience are vital in the design and management of these five elements to ensure a successful, cost-effective house construction project. Professional construction management is essential to navigate these complexities, offering the necessary expertise and oversight to keep the project on track.

The foundations are the bedrock of any project, and unforeseen costs here can be disastrous. Do not assume that your structural engineer will automatically provide the most economical solution because it is not their job. They will follow the directions of the Client and other technical advisors and it is up to you or your Construction Manager (CM) as to what type of foundation should be installed.

Sub-soil & Site Surveys

The only way to avoid catastrophic unforeseen costs is to carry out appropriate sub-soil surveys. The complexity of these surveys varies: some sites may only require simple test pits and lab testing, while others demand comprehensive boreholes and sleeve testing.

  • Avoid Over-Testing: You need detailed knowledge about the site’s conditions, not advisory reports that may exaggerate issues to justify additional, expensive testing.
  • CM Interpretation: The Construction Manager (CM) must provide the appropriate Terms of Reference for these surveys and, with the Structural Engineer, accurately interpret the results.
  • Environmental Surveys: Flora, fauna, and tree surveys are often conditions of planning consent. The CM must carefully draft the Terms of Reference to avoid unnecessary delays and extra cost.

Strip Footings: The Standard for House Construction

For centuries, UK dwellings have relied on simple strip foundations. Today, the minimum required depth is 1m, which is generally adequate.

  • ICF Advantage: Insulated Concrete Formwork (ICF) walls create a rigid box that actually strengthens the foundation, making it less reliant on perfect ground conditions compared to traditional cavity wall construction.
  • Unsuitable Conditions: Soft, unstable, or expansive soils, high water tables, thick made ground, or areas prone to seasonal moisture fluctuation (Ground Heave) can make strip foundations unsuitable for cavity walls or timber frame but still be suitable for ICF.

Addressing Challenging Ground Conditions

While strip footings are the standard for most house construction, severe conditions require alternative solutions like rafts or, rarely, piling.

  • Soft, Unstable Soils: Common in floodplains and peat-rich areas. Using ICF in these zones can often save substantial foundation costs.
  • High Water Table: Makes construction difficult and verification of the subsoil challenging. Dewatering wells can significantly reduce delays and provide large overall savings. Fluctuating water levels can also lead to high future heating bills and cut-off walls can sometimes be economical to install.
  • Ground Heave: Caused by shrinking and swelling clay soils. The stiffening effect of ICF walls significantly minimizes the potential for heave to cause wall cracks.
  • Made Ground: If this layer is unexpectedly deep (over 1.5m), it can cause significant delays and costs if not discovered during initial surveys.

Rafts & Piling Alternatives

When strip footings are infeasible, the next steps are usually raft foundations or, as a last resort, piling.

  • Rafts: Raft foundations mitigate ground issues by spreading the building load widely and using rigid structural design. In most modern residential buildings, a 200 mm deep raft is adequate, especially when supporting stiff ICF walls.
  • Piling: Extremely costly and should be avoided if at all possible. Screw piles are one of the only systems that may be economically justified in residential building, primarily used to protect tree roots or match complex ground profiles.
Construction Management
DOn’t leave your build to chance.

Protect your investment from the elements. Speak to our experts to ensure your shell is wind and weathertight—built right, on budget, the first time.

Achieve Wind & Weathertight status quickly.

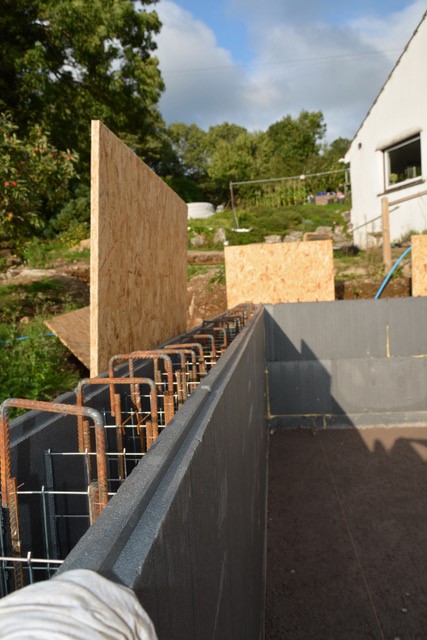

icf-basement-wall-construction

The wall system defines the structural integrity and long-term performance of your house construction in terms of insulation, fire safety, and soundproofing.

Cavity Wall, Timber Frame or ICF

While traditional cavity walls and timber frames remain common, ICF is an advanced building system that is rapidly replacing them as a primary method for residential units.

ICF homes offer superior performance because they provide:

  • Air-tight, fire-proof, and noise-proof buildings.
  • Subsidence-resistant structures.
  • High thermal mass at economic costs.
  • Fast construction without reliance on highly skilled labour.
  • Steelwork Reduction: Many cavity wall and timber frame projects require costly steel frames. If an experienced Structural Engineer is commissioned, ICF can replace the steelwork in most projects, avoiding months of site delays and expensive pad footings.

Floors provide structural support and are key to achieving modern energy efficiency standards.

Ground Floor Requirements

New building standards require very low floor U-values (0.13 W/m2K). Ground-bearing slabs are often easier to integrate with ICF walls than suspended floors (beam & block or timber), as they avoid the need for complex cutting around the precast beams of a beam and block floor.

Floor Type

Advantages

Disadvantages

Ground-Bearing Slab

1) Less insulation required because no air circulation beneath the floor
2) Easy to install with ICF walls

1) May need existing soft soil to be removed and replaced with numerous layers of granular soil
2) Add to the thermal mass

Suspended Timber

1) The void increases heat losses
2) Air-tigtness is difficult to provide​
3) Susceptible to long term rot
4) Oversite concrete is still required
5) Prone to vermin problems
6) Do not add thermal mass

Beam and Insulation

​1) Quick and easy to install

1) The void increases heat losses
2) Air-tigtness is difficult to provide​
3) High cost
4) Oversite concrete is still required
5) Prone to vermin problems
6) Do not add thermal mass

Upper Floors

Upper floors must balance span capability, acoustics, and ease of installation.

Aspect

Beam and Block (Concrete)

Timber Joists (Traditional Softwood)

Engineered Timber (I-Joists or Metal Web)

Construction

Precast beams with infill blocks on walls/beams

Solid softwood joists spanning walls

I-beams (OSB web) or open metal webs

Span Capability

Up to 8m, high load for flats/multi-story

Limited (4-6m), needs supports

6m+, lightweight for open plans

Installation Speed

Quick, dry-laid but heavier

Site-built, labor-intensive

Fastest, pre-fabricated

Durability/Longevity

150+ years, no shrinkage/creak

60 years, prone to rot/shrinkage

Shrink-resistant, quiet floor

Sound Insulation

Excellent mass for separating dwellings

Poor without upgrades

Good with design

Fire Resistance

High, non-combustible

Lower, needs treatment

Improved but timber-based

Cost (incl. labour)

£81/m², higher material

£58/m², affordable

2x softwood but versatile

Suitability

Masonry/ICF, sound-critical

Traditional, budget builds

Modern open-plan, services routing

ICF walls are highly versatile and can support any of the suspended floor types by simply installing the appropriate fixings into the concrete core before it is poured.

The primary cost of the roof is controlled by the finish specified on the planning consent drawings. Most modern roofs will incoporate trusses designed and supplied by a specialist.

Truss Roofs vs. Cut Roofs

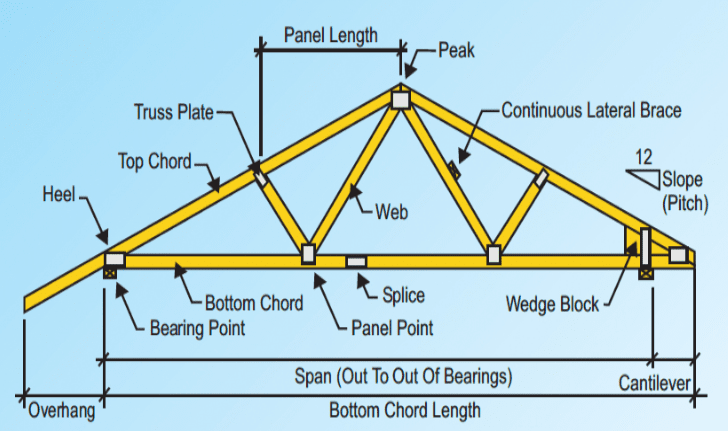

Roof Trusses: Factory-prefabricated for fast installation, limiting site assembly. Delivery constraints typically limit single-piece spans to 12-15m in the UK. Trusses limit attic space and design flexibility.

house-construction-roof-truss

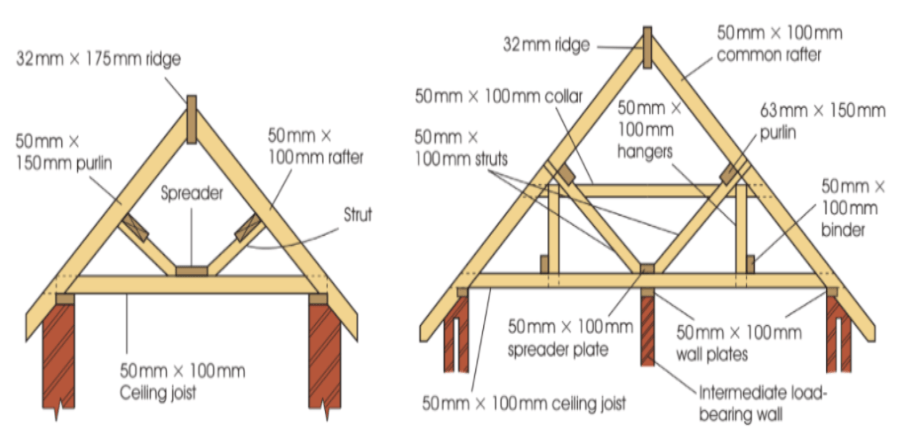

Cut Roofs: Traditional pitched roof construction where components (rafters, purlins, etc.) are cut and assembled on-site by skilled carpenters. Cut roofs offer superior customization for complex shapes and enable attic conversions, but require more time and skilled labour.

house-construction-cut-roof

Roof Coverings

The planned pitch of the roof directly dictates the type of tile or slate that can be used. This choice must be aligned with the aesthetic requirements imposed by the planning consent and must be factored into the overall budget.

While the planning consent may not impose a detailed specification for windows and doors, the final choice significantly affects the project budget and is critical for the schedule.

  • Budget Impact: The choice of window frame material (PVC/uPVC, Aluminium, Steel, or Timber) can greatly vary the cost.
  • Critical Path Risk: Late deliveries are a frequent cause of budget overruns because scaffolding cannot be removed until the upper floor windows are installed. It is essential that the window type is identified and ordered in a timeframe that meets the Critical Path in the Schedule.
Construction Management

Ready To Control Your Project Costs?

Talk to the ICF Designs team today to discuss your project requirements and learn how our Structure and Shell service can secure your budget and schedule up to the critical Wind and Weathertight stage.
